Work on the Upstream Gate of the Joubert Sluice Dock in Saint Nazaire
The replacement of the upstream gate of the Joubert sluice dock is intended to enhance the structure’s reliability, to extend its service life and to improve the level of service provided for maritime and land-based activities. This new gate will also open up new development opportunities for stakeholders in the sector. This major work project will begin in the spring of 2026 and will be completed in early 2029.

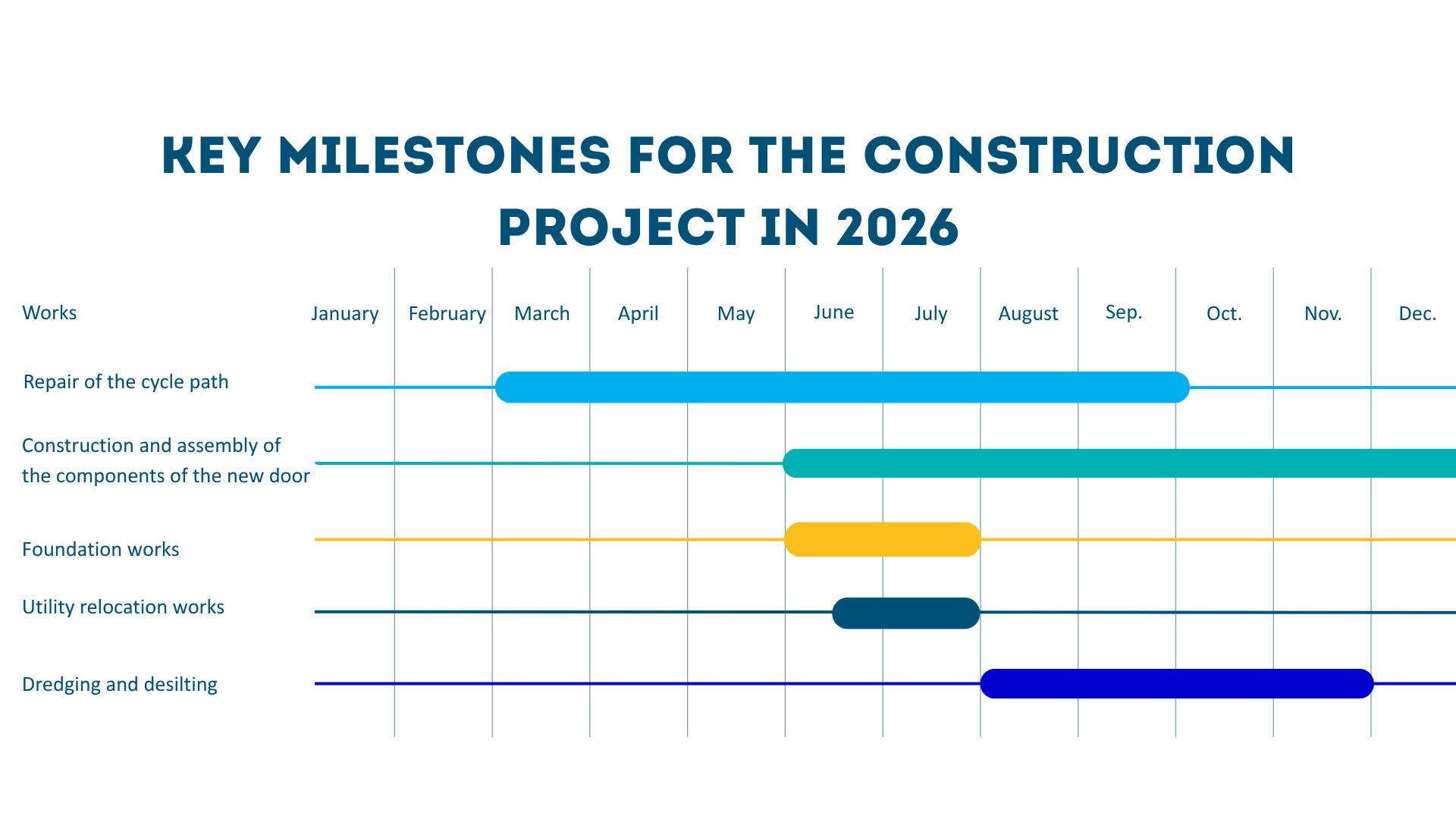

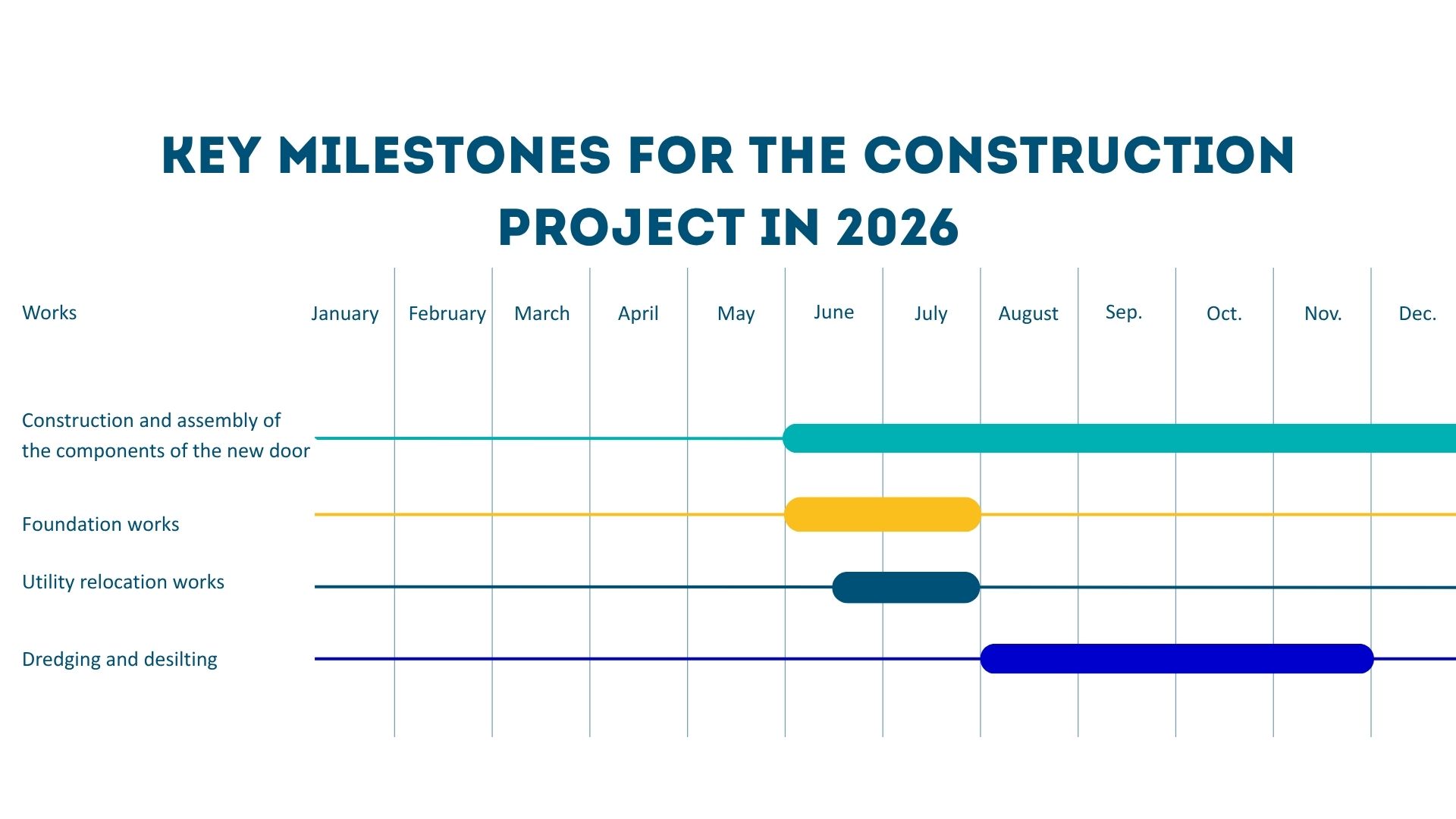

Traffic around the Joubert Sluice Dock and Progress of the Work
SPECIFICATIONS OF THE JOUBERT SLUICE DOCK
SPECIFICATIONS OF THE JOUBERT SLUICE DOCK
At the Port of Saint Nazaire, construction work on the Joubert sluice dock began in 1930, coinciding with the building of the cruise liner Normandie. The work was completed in 1934, and the structure was named in honour of Louis Joubert, then President of the Chamber of Commerce and Industry. The sluice dock suffered severe damage in March 1942 during Operation Chariot, when the destroyer Campbeltown collided with its downstream gate.
Serving both as an access lock to the Penhoët dock basin and as a dry dock for taking vessels out of the water, the sluice dock’s dimensions are remarkable: it measures 350 metres in length, 50 metres in width and 17 metres in depth. It is closed by two "barrow-type" rolling gates, which were rebuilt after the war. These gates move horizontally along rails to open or close the lock, then slide into their recesses once open. An entirely new gate replaced the downstream gate on the River Loire side in 2012.
The upstream gate, which was installed back in 1947, is now in such a state of disrepair that it must be replaced.
A Strategic Structure Right in the Heart of the Port of Saint Nazaire
A strategic piece of infrastructure for both military and civilian activities, the Joubert sluice dock plays a central role in Saint Nazaire’s maritime and port ecosystem. Its exceptional dimensions enable it to accommodate not only French Navy vessels but also cruise ships under construction at the Chantiers de l’Atlantique Shipyard, as well as projects for offshore wind farms along France’s Atlantic Seaboard. Ensuring its smooth operation is essential for the local economy and the Region Community’s industrial sectors.
FINANCING
This investment operation was approved by the Supervisory Board of Nantes ‒Saint Nazaire Port in November 2024, involving a substantial expenditure in the amount of 40 million euros.
